How to Prototype a SaaS Product in Two Weeks: From Clickable Mockup to Working Pilot

Saas Product Development
How to Prototype a SaaS Product in Two Weeks: From Clickable Mockup to Working Pilot
Nilesh K.

Written by

Nilesh K.

Updated on

September 24, 2026

Read time

11 mins read

Quick Answer: A SaaS prototype is the cheapest object that lets real users attempt the product’s core journey while you watch where they fail. In two weeks: week one scopes a single journey, designs a clickable prototype, and tests it with five users; week two fixes what those tests broke, builds a thin backend for the one journey that must be real, deliberately fakes the rest, and puts a pilot live with real users and real stakes.

The five-user number isn’t folklore: Nielsen Norman Group’s research found a first test round with five participants uncovers about 85% of usability problems, after which fixing and retesting beats recruiting more users. The rest of this playbook is the tier table, the day-by-day schedule, the three pilot metrics, and the honest line between a fair prototype and a misleading demo.

This playbook picks up exactly where the validation framework ends. You’ve run the tests; the demand is real. Now two audiences are asking for the same impossible thing on the same short clock: investors want to see something working, users need something to react to, and the full build is months away. The trap is treating this as a small version of the build. It isn’t. It’s a different object with a different job, and the job fits in two weeks precisely because of what you refuse to build.

There’s a saying at IDEO, the firm that made prototyping a discipline, that captures why the object is worth two weeks of anyone’s life:

“If a picture is worth 1,000 words, a prototype is worth 1,000 meetings.”

A saying at IDEO, via Tom and David Kelley, Creative Confidence

Meetings argue about what users would do. A prototype lets you watch what they actually do, and the watching is the product of this fortnight. Here’s how we run it as a SaaS development company: the tiers, then the schedule, then the measurements.

What a Prototype Is For: Learning, Not Launching

A prototype exists to answer questions cheaply, and every decision in the next two weeks follows from naming the question first. “Do users understand what this is and want to proceed?” is a question a clickable mockup answers. “Does the workflow survive contact with real data?” needs a working journey. “Can we handle 10,000 users?” is not a prototype question at all; it’s a build question wearing a costume, and trying to answer it now is how two weeks become two months.

The corollary founders resist: prototype code is scaffolding, not foundation. The thin backend you write in week two exists to produce learning, and most of it should be cheerfully discarded when the real build starts, the same way a movie set isn’t the first floor of a real building. Teams that promote prototype code into production are laying the first bricks of the pattern we mapped in the hidden APR of cheap code: a fortnight’s shortcuts financed at compound interest. Write it fast, learn from it, and let it go.

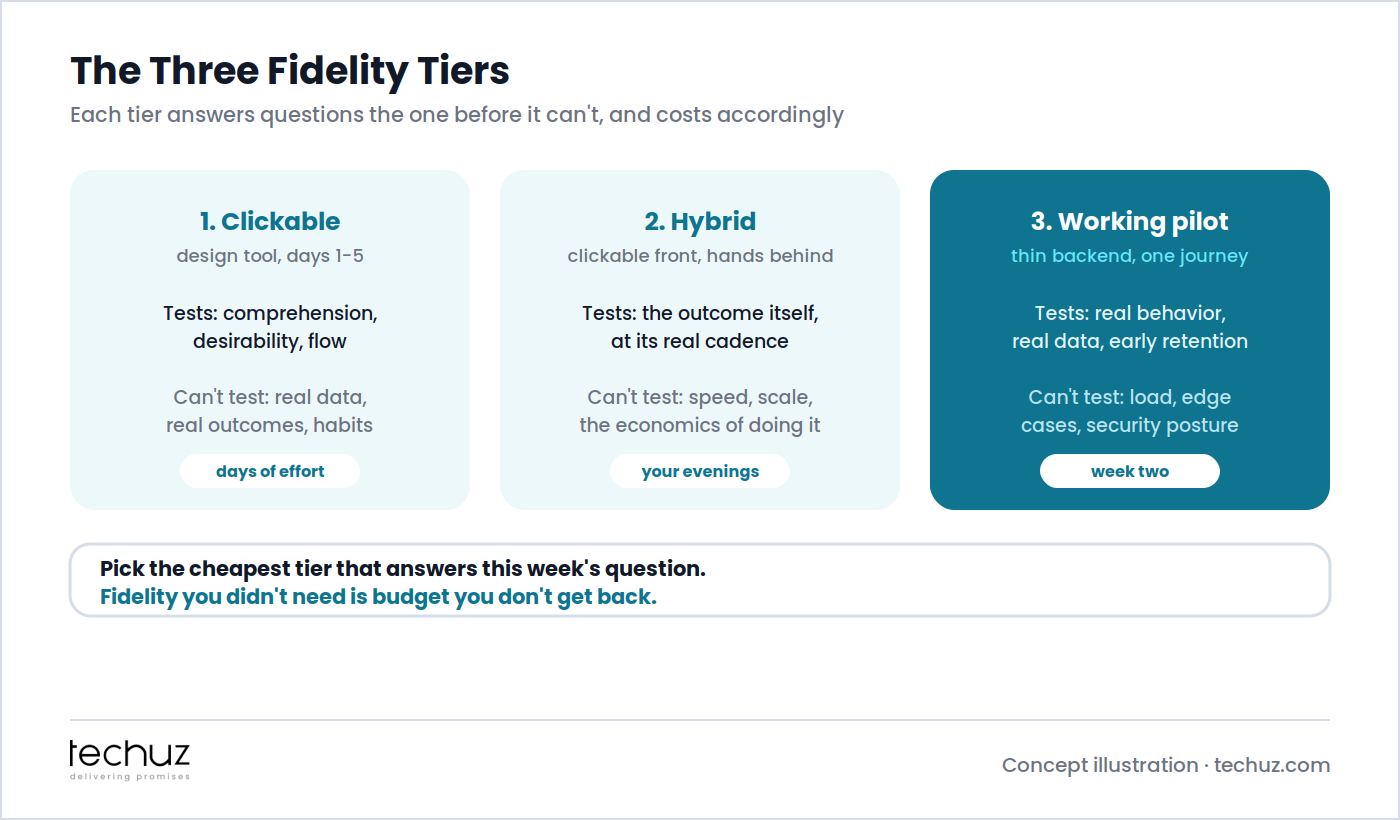

The Three Fidelity Tiers

The three fidelity tiers: a clickable design prototype testing comprehension and desirability, a hybrid with a clickable front and hands behind it testing the outcome, and a working pilot on a thin backend testing real behavior and early retention
Tier Builds in Tests Can’t test Cost
1. Clickable prototype A design tool (Figma or similar), screens wired with hotspots Comprehension, desirability, flow, and where eyes stall Real data, real outcomes, habits Days of design effort
2. Hybrid (clickable front, hands behind it) The clickable, plus you fulfilling the outcome manually behind the curtain Whether the outcome itself is wanted, at its real cadence Speed, scale, the economics of delivering it Your evenings
3. Working pilot A thin backend behind the one journey that must be real Real behavior with real data, and the first retention signal Load, edge cases, security posture Week two

The rule that keeps the fortnight honest: pick the cheapest tier that answers this week’s question. Fidelity you didn’t need is budget you don’t get back, and the most common two-week failure is spending both weeks polishing tier 1 because polishing feels like progress. The schedule below exists to prevent exactly that.

Week One: One Journey, One Clickable, Five Users

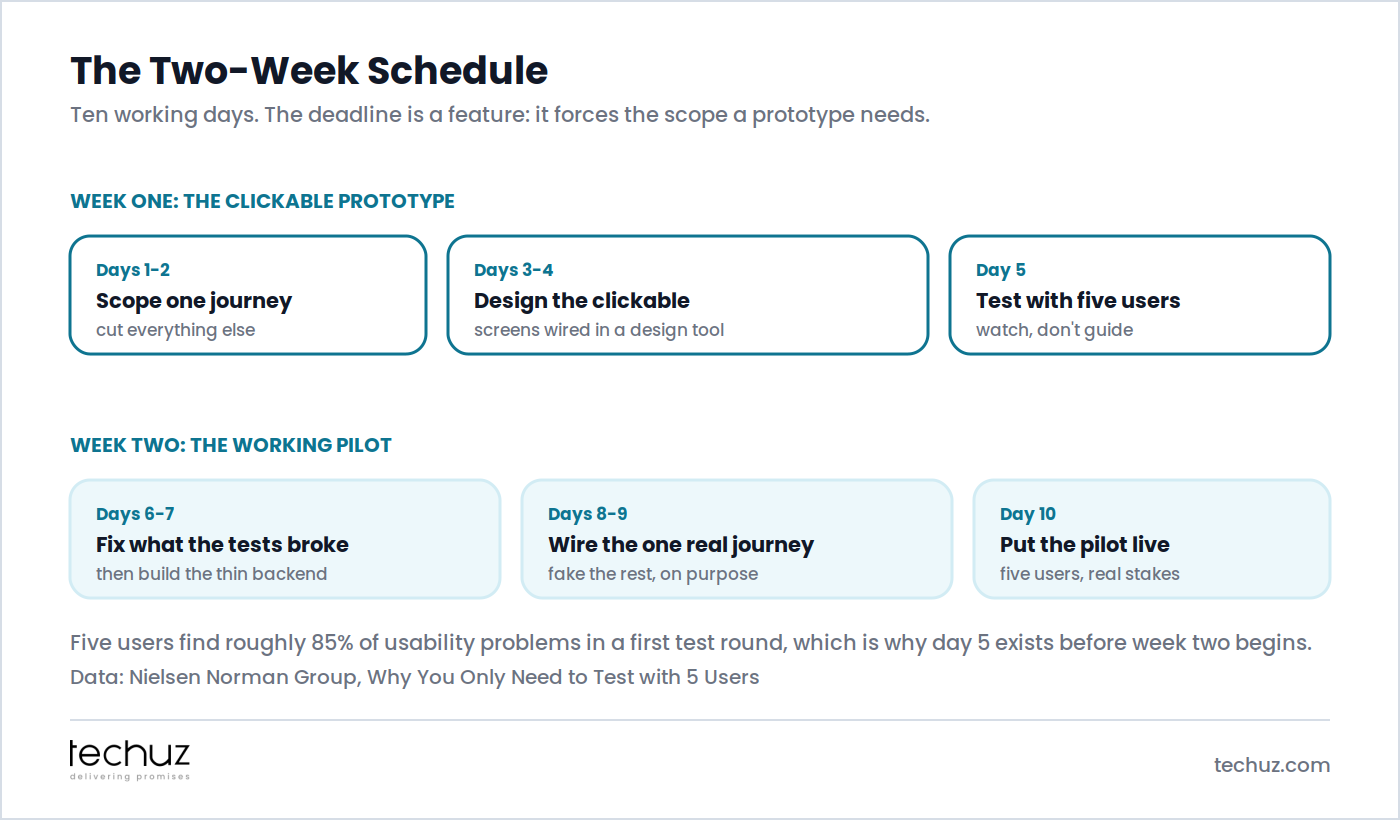

The two-week schedule: days 1-2 scope one journey, days 3-4 design the clickable, day 5 test with five users; days 6-7 fix what the tests broke and build the thin backend, days 8-9 wire the one real journey and fake the rest on purpose, day 10 put the pilot live. Five users find roughly 85% of usability problems in a first test round

Days 1-2: scope the one journey that matters. Not the feature list: the single path a first-time user takes from arriving to receiving the core value. “Paste a job posting, get a ranked shortlist, export it.” Write it as numbered steps on one page, then cut: no settings, no team management, no billing, no second persona. Everything cut is written on a “later” list so the team stops relitigating it. If the journey doesn’t fit on a page, you’re prototyping two products; pick one.

Days 3-4: design the clickable. Every screen in the journey, wired together in a design tool so it feels navigable, with one discipline that separates useful prototypes from pretty ones: realistic content, not lorem ipsum. Real-looking job postings, plausible names, believable numbers, because users react to content, and placeholder text quietly hides the comprehension problems you’re paying to find. Speed matters more than polish; this is also where professional UI UX design earns its keep, since a practiced designer produces in two days what takes a founder two weeks.

Day 5: test with five users. Recruit from your validation waitlist or pilot group (people with the problem, not colleagues), give each a task, not a tour (“you need a shortlist for this role; go”), and then do the hardest thing in the whole playbook: watch in silence. Every time you explain, you erase a finding. NN/g’s research is blunt about why five is the number: a first round with five participants surfaces about 85% of the usability problems, and the better use of a sixth user is testing the fixed version later. By Friday evening you have a ranked list of everything that confused real people, which is the most valuable document the project owns.

Week Two: The Thin Backend, and Faking the Rest on Purpose

Days 6-7: fix what the tests broke, then build thin. The morning is design fixes from day 5. The rest is the thin backend for the one journey: the simplest stack your team already knows (this is no moment for new technology), one data store, deployed anywhere simple. Auth can be magic links; the admin panel can be a database GUI; email can be you.

Days 8-9: wire the real journey, fake everything else deliberately. The core journey works end to end with real data. Around it, choose your fakes consciously: the “integrations” page is a static screen, the recommendation engine is a rules file or you personally curating results overnight, notifications are hand-sent. Deliberate faking is a legitimate, honorable prototyping tool with one governing rule we established in the Wizard of Oz post: fake only what you know how to build. A human behind the curtain standing in for engineering you could do is a schedule shortcut; a human standing in for capabilities you don’t know how to build is a demo writing checks the build can’t cash, and it converts your prototype’s findings into fiction.

Day 10: the pilot goes live. Five to ten users from the validation cohort, using it for real work, knowing it’s an early pilot. Real stakes, honest framing, and the meters below already agreed.

Need something real in front of investors this month?

Techuz rapid prototyping engagements run this exact fortnight: the scoped journey, the clickable, five user tests, the thin-backend pilot, and the findings report, with senior design and engineering on both weeks.

Book the two weeks

What to Measure in the Pilot

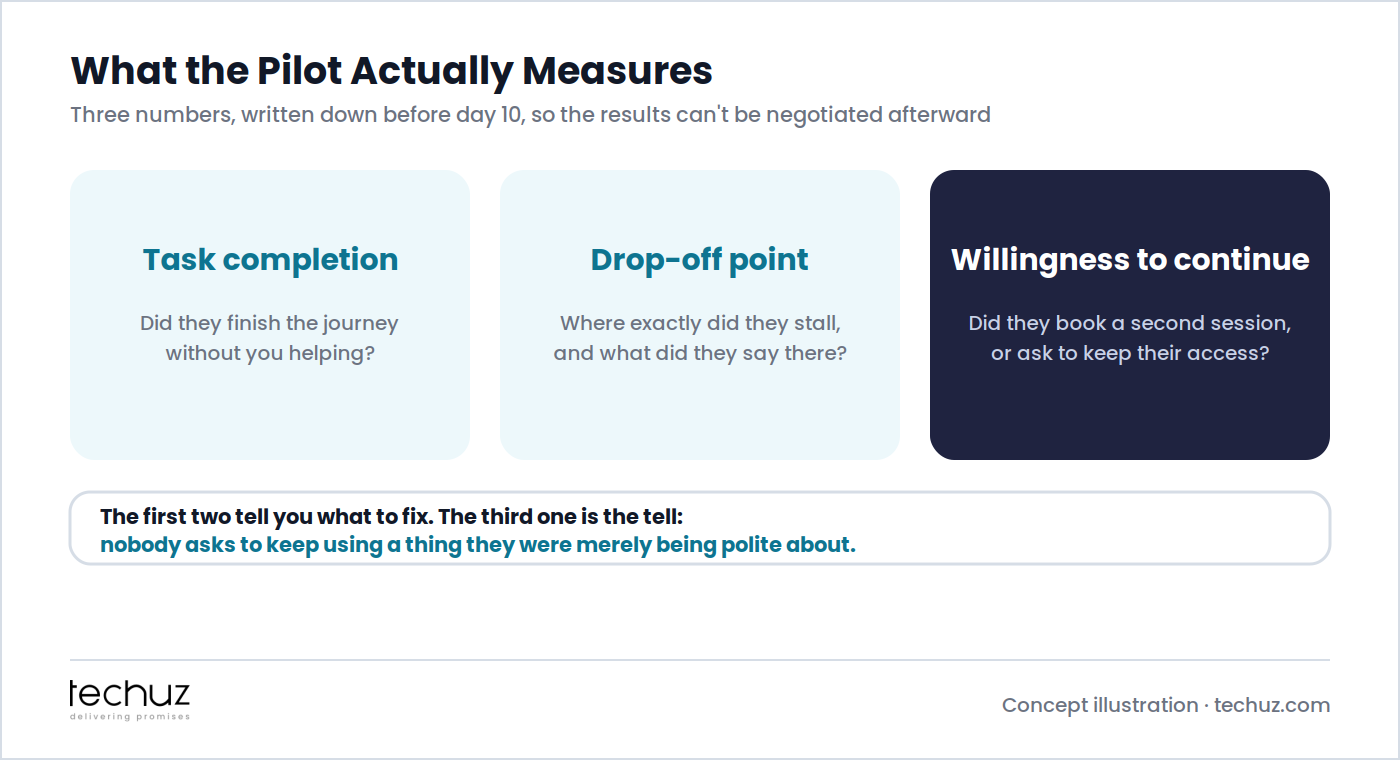

What the pilot measures: task completion without help, the exact drop-off point and what users said there, and willingness to continue shown by booking a second session or asking to keep access

Three numbers, written down before day 10 so the results can’t be negotiated afterward. Task completion: did they finish the journey without you helping? A pilot where three of eight complete unaided is telling you something a demo never would. The drop-off point: where exactly did the others stall, and what did they say there? The location of failure is the spec for the next iteration. Willingness to continue: did they book a second session, or ask to keep their access when the pilot window closed? The first two tell you what to fix. The third is the tell, for the same reason week-four retention anchored the validation framework: nobody asks to keep using a thing they were merely being polite about.

The Line Between a Fair Prototype and a Misleading Demo

The same object plays two rooms in the same fortnight, and the disclosure rules differ. With users, fakery needs no announcement; you’re testing their behavior, and the curtain is the method. With investors, the line is bright: show the prototype proudly, and answer “is this working?” with the truth: “this journey is real; these parts are simulated and here’s the build plan for them.” Sophisticated investors have seen a thousand demos, and the founder who volunteers the seams reads as credible while the founder caught hiding them reads as radioactive; this is the exact dynamic we dissected in the Sugar Rush MVP post, where speed impressed nobody once credibility cracked. The prototype’s job with investors isn’t pretending to be the product. It’s proving you know precisely what the product must do, because you watched ten real people try it.

Turning Prototype Learnings into a Build Spec

The fortnight’s real deliverable is a build spec with evidence attached, and it has four parts: the journey map annotated with observed failures (“4 of 8 stalled at the export step, all for the same reason”), the ranked fix list from both test rounds, the deliberate-fakes register with what replacing each one actually requires, and the pilot metrics as the baseline the real product must beat. That document changes the economics of everything after it: scope debates get settled by observations instead of opinions, estimates attach to journeys users completed rather than features imagined, and the thin backend retires with honor. Walking into a build with that file is the difference between commissioning software and commissioning an experiment at software prices, and it’s the artifact any competent web development services partner should ask to see before quoting.

From pilot findings to production build

As a SaaS MVP development company, Techuz takes the two-week prototype and its findings straight into a scoped build, so the spec is written by observed behavior rather than by a brainstorm.

Start a conversation

FAQs

What is the difference between a clickable prototype and an MVP?

A clickable prototype is wired screens with no real backend: it tests comprehension and desirability in days. An MVP is a real, if minimal, product that users adopt over weeks. The two-week playbook sits between them: a clickable in week one, and a working pilot (one real journey on a thin backend) in week two, producing the evidence that makes the eventual MVP build a safer bet.

How many users should test a SaaS prototype?

Five per round, per the Nielsen Norman Group’s finding that a first test with five participants surfaces about 85% of usability problems. The productive move after five is fixing and retesting with a fresh five, not recruiting more into the same round. Recruit people who actually have the problem, give them a task rather than a tour, and watch without helping.

Can I show a prototype to investors, or does it need to be a working product?

Show the prototype, and volunteer the seams: which journey is real, which parts are simulated, and what the build plan is for each. Investors evaluate whether you understand your product and users, and a prototype backed by pilot observations demonstrates that better than a fragile full build. What damages credibility isn’t fakery; it’s concealed fakery discovered by a question.

What should the prototype fake, and what must be real?

The core value journey must be real end to end with real data, because that’s where behavior and retention signals live. Everything around it can be faked deliberately: static settings pages, hand-run fulfillment, manual notifications, with one rule: only fake capabilities you know how to build. Faking the impossible turns your findings into fiction and your demo into a liability.

How much does it cost to prototype a SaaS product?

Run internally, the cost is two focused weeks from a designer and a developer plus small tooling fees. As an engagement with a product prototyping services team, it’s a fixed two-week sprint, typically a small fraction of the full build’s budget. Either way it’s the cheapest insurance in product development: it converts the largest unknowns (will users understand it, complete it, and want to keep it) into observations before the expensive decisions are made.
